How long does a bathroom remodel take?

On site, a straightforward full bathroom remodel runs about two to three weeks of work. A primary suite with a curbless shower, a freestanding tub and a moved wall runs four to six. A powder room refresh can be done in under a week.

Those are the numbers people quote, and they’re the numbers that cause arguments, because they describe the construction. The calendar from the day you decide to the day you shower in it is usually two to three times longer. Almost none of the extra time is crew time.

Here’s where it actually goes.

Before anyone swings a hammer

Design and selections: one to three weeks. This is the phase homeowners underestimate and the phase that determines everything downstream. Tile, vanity, fixtures, glass, paint, and the layout they all sit in. Nothing can be ordered until it’s chosen, and nothing can be scheduled until it’s ordered.

Ordering and lead times: one to eight weeks, running in parallel. Stock tile and a stock vanity can be at the house in days. A custom vanity, a specific slab, or a made-to-order glass enclosure is where weeks disappear. Frameless shower glass is the classic one: it can’t even be measured until the tile is finished and cured, so it’s ordered mid-project and arrives one to three weeks after that.

Permits, when the job needs them: variable. Whether a bathroom remodel needs a permit turns on scope, and the call belongs to the city rather than to a guide. In the City of San Diego that goes through Development Services. The bathroom remodel permit guide covers what usually triggers one. Ask your contractor to confirm the scope with the city early, because permitting sits on the critical path and adding it late stops everything.

HOA review, in a condo or a planned community: two to six weeks. This is the single most underestimated item in San Diego, and it hits hard in Rancho Bernardo, Rancho Peñasquitos, San Elijo Hills and most coastal condo buildings. The association reviews on its own schedule, not yours. It’s free to start early and expensive to start late.

The construction phases

Once work starts, a full bathroom moves through roughly this order. Phases overlap, but the sequence rarely changes, because each one has to cure or be inspected before the next covers it up.

Demolition: one to two days. Fixtures out, tile off, and the wet wall opened up. Fast, loud, and the phase where surprises surface.

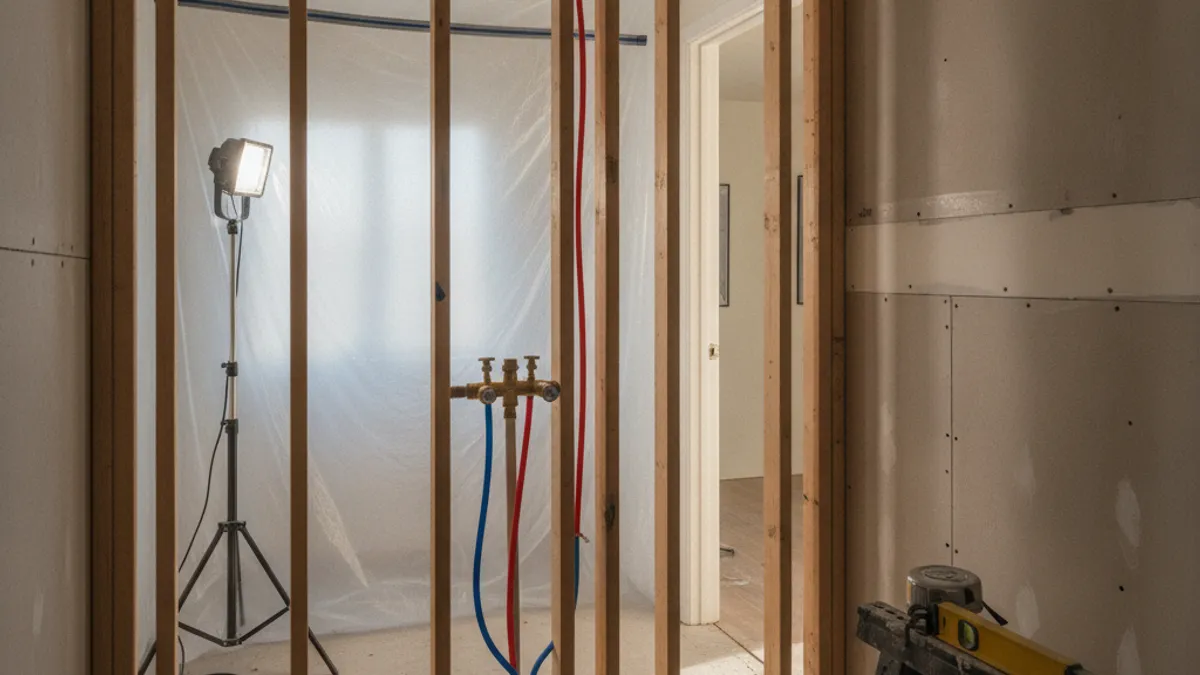

Rough plumbing and electrical: two to four days. Drain moves, new supply lines, the shower valve, and any new circuits or lighting. If the house has galvanized or polybutylene supply lines, this is the moment to replace the accessible runs, because the wall will never be this open again. The plumbing and repipe guide covers what that involves.

Inspection, on a permitted job: one to five days of waiting. The wall stays open until the inspector clears it. This is dead time on the calendar and there’s no way to compress it.

Waterproofing and backer: one to two days, plus cure time. Membrane over the shower walls and pan. Some systems need to sit before tile goes on. Skipping the cure is how showers leak in year four.

Tile: three to six days. The longest single phase in most bathrooms, and the one most affected by tile choice. Large format porcelain on a flat wall goes fast. Mosaic, herringbone, or anything that needs cuts around a niche goes slow. Grout adds a day, and it needs to cure before the shower gets used.

Glass measure and install: one to three weeks after tile. The measure happens once tile is set. Then the glass is fabricated. This is usually the last thing to arrive and the reason a bathroom sits “almost finished” for a fortnight.

Vanity, fixtures, paint and punch list: two to four days. Vanity set, top installed, faucets and trim on, mirror hung, paint touched up, and the list of small things nobody notices until they do.

The four things that actually stretch a bathroom remodel

1. Deciding late. Every selection not made before demo is a day the crew can’t work or a day the schedule waits on shipping. The single biggest thing a homeowner controls is finishing selections early.

2. What’s behind the wall. Rot in the subfloor under an old shower pan, a drain that turns out to be cast iron and cracked, or supply lines that are worse than expected. This is real, it’s common in older San Diego housing stock, and it’s the reason a contingency exists. It typically adds two to five days.

3. Glass. Almost always the last item and almost always underestimated. If the schedule matters, ask what the fabricator’s current lead time is before the job starts, not after.

4. Moving plumbing. A shower drain that stays put costs days. A drain that moves in a slab-on-grade home means cutting the slab, re-plumbing, patching and waiting for the patch. In most of Poway, Santee, Rancho Bernardo and San Marcos, that’s what a layout change means.

Can you live in the house during it?

Usually yes, and most San Diego households do, even with a single bathroom.

A crew that’s done this before phases demolition and rough work so the house closes up at night, sets dust containment with an air scrubber, and keeps a route to the front door clear. With one bathroom in the house, ask about a temporary toilet plan before demo day rather than the morning of.

What you don’t get is a working shower for the middle stretch. Plan for a gym, a neighbour, or a relative for roughly a week and a half in a standard full remodel.

Frequently asked questions

How long does a small bathroom remodel take?

A powder room or half bath with no shower usually runs three to five days of construction, since there’s no waterproofing, no tile pan and no glass. A full hall bath at 5 by 8 feet runs closer to two weeks.

How long does a master bathroom remodel take?

Four to six weeks of construction is typical once a curbless shower, a freestanding tub, a double vanity or a wall move are involved. Add the selection and ordering time in front of it and the calendar is often three months.

Why does the shower glass take so long?

It can’t be measured until the tile is finished, so it’s ordered partway through the job rather than at the start. Fabrication then takes one to three weeks. It’s the most common reason a bathroom looks done but isn’t usable.

Does a permit make the job longer?

It can, because inspections sit on the critical path and the wall has to stay open until the inspector signs off. The delay is measured in days, not weeks, as long as the permit is pulled early rather than mid-project.

What’s the longest phase?

Tile, at three to six days for most bathrooms, and longer with mosaic or intricate patterns. The longest wait, though, is usually the glass.

How Bath Pro SD helps

Bath Pro SD is a referral service. We match you with licensed, insured local bathroom crews across San Diego County who’ll walk your bathroom, tell you what’s likely behind the wall, and give you a schedule based on your actual scope rather than an average.

The crew does the work and sets the schedule, and you contract with them directly. If you’re still working out scope, the bathroom remodel cost guide covers what drives the number, and the master bathroom remodel guide covers the bigger projects.

Call (858) 400-4896 and leave the details. We’ll match you with a crew that works your area.
